Ellis Strategic Holdings
508–510 E. Breckenridge Redevelopment
Lender Information Package prepared for financing conversations related to the redevelopment of 508–510 E. Breckenridge Street in Louisville, Kentucky.
Welcome
Thank you for taking the time to meet with Samuel D. Ellis and review the 508–510 E. Breckenridge redevelopment project.
Ellis Strategic Holdings is seeking lending relationships to support the redevelopment of an existing mixed-use property into a stabilized, income-producing community asset.

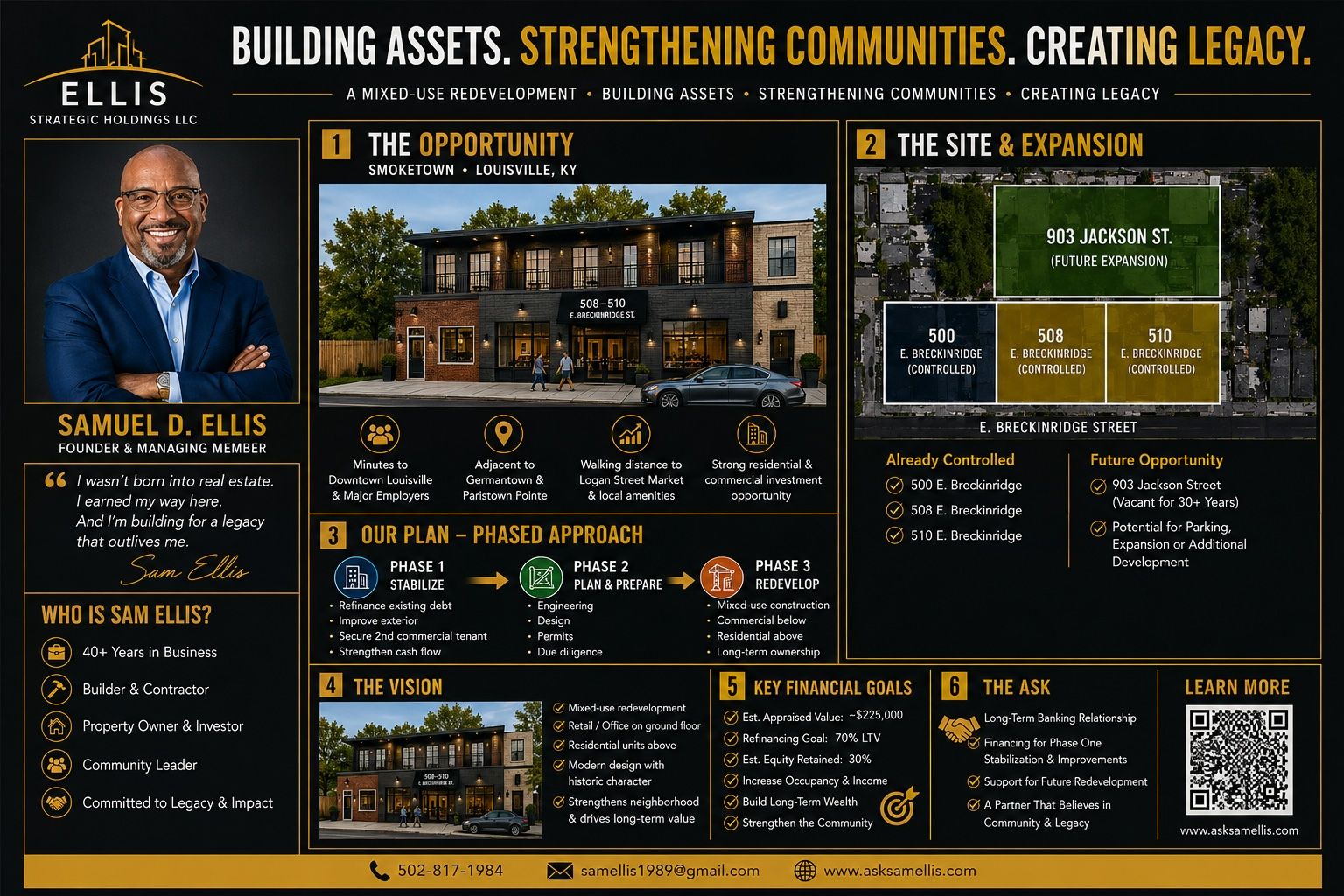

Project Snapshot
508–510 E. Breckenridge Redevelopment

Louisville, Kentucky
Mixed-Use / Rental / Rehabilitation
Project Vision
Every building has a story. The 508–510 E. Breckenridge property has served the city for years, and Ellis Strategic Holdings is working to write its next chapter.

The goal is to preserve an existing neighborhood asset, improve the property, create stabilized rental income, and establish a strong foundation for future development work.

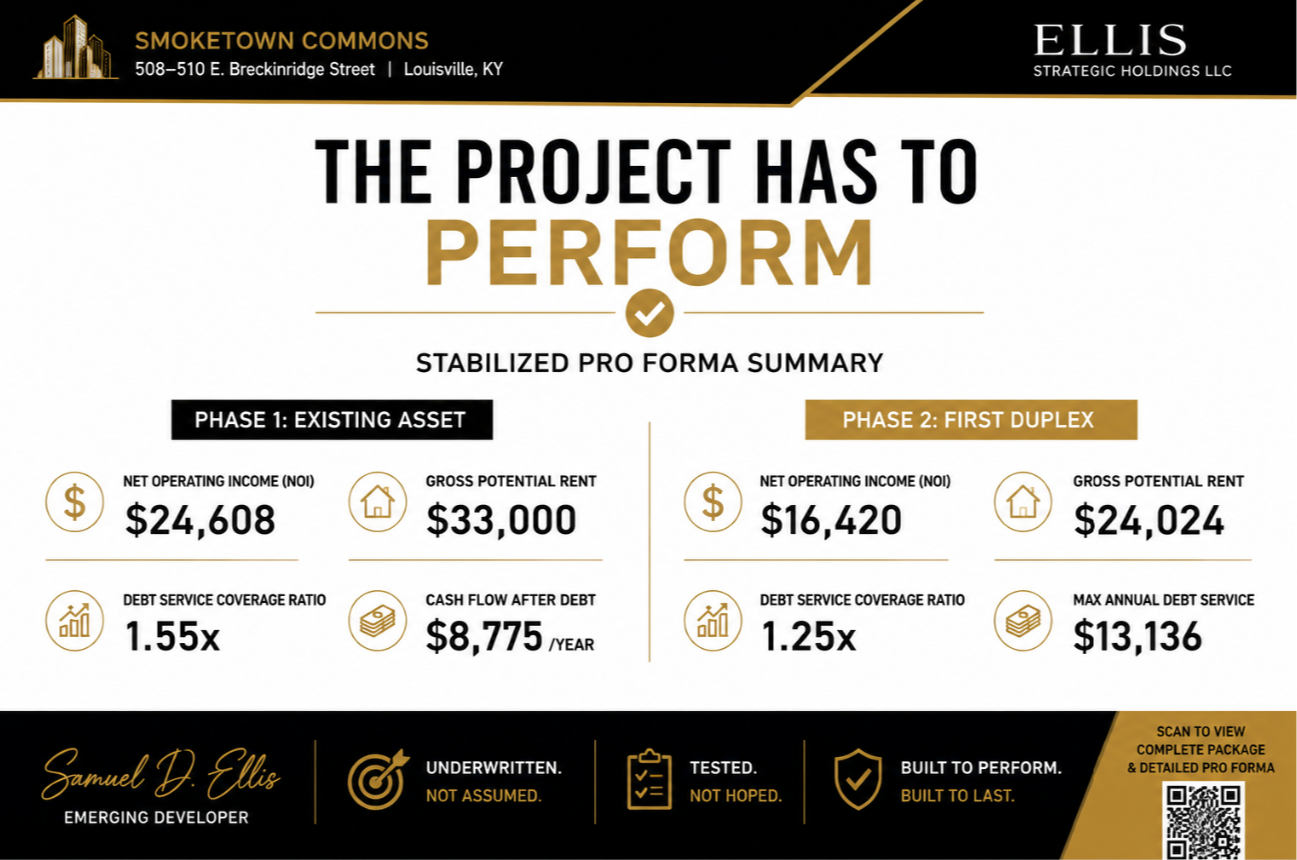

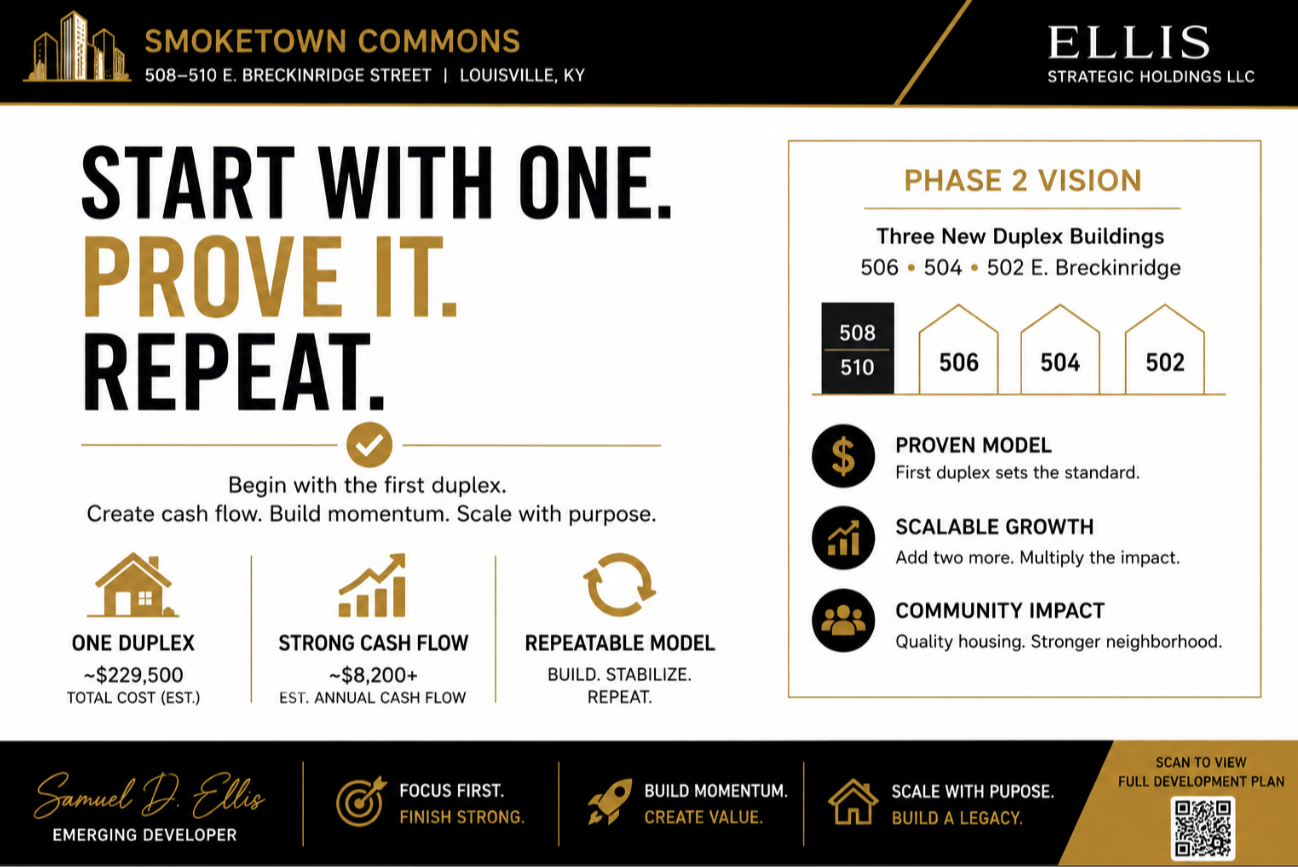

Lender Documents
Please click below to review the key project documents.
About Samuel D. Ellis

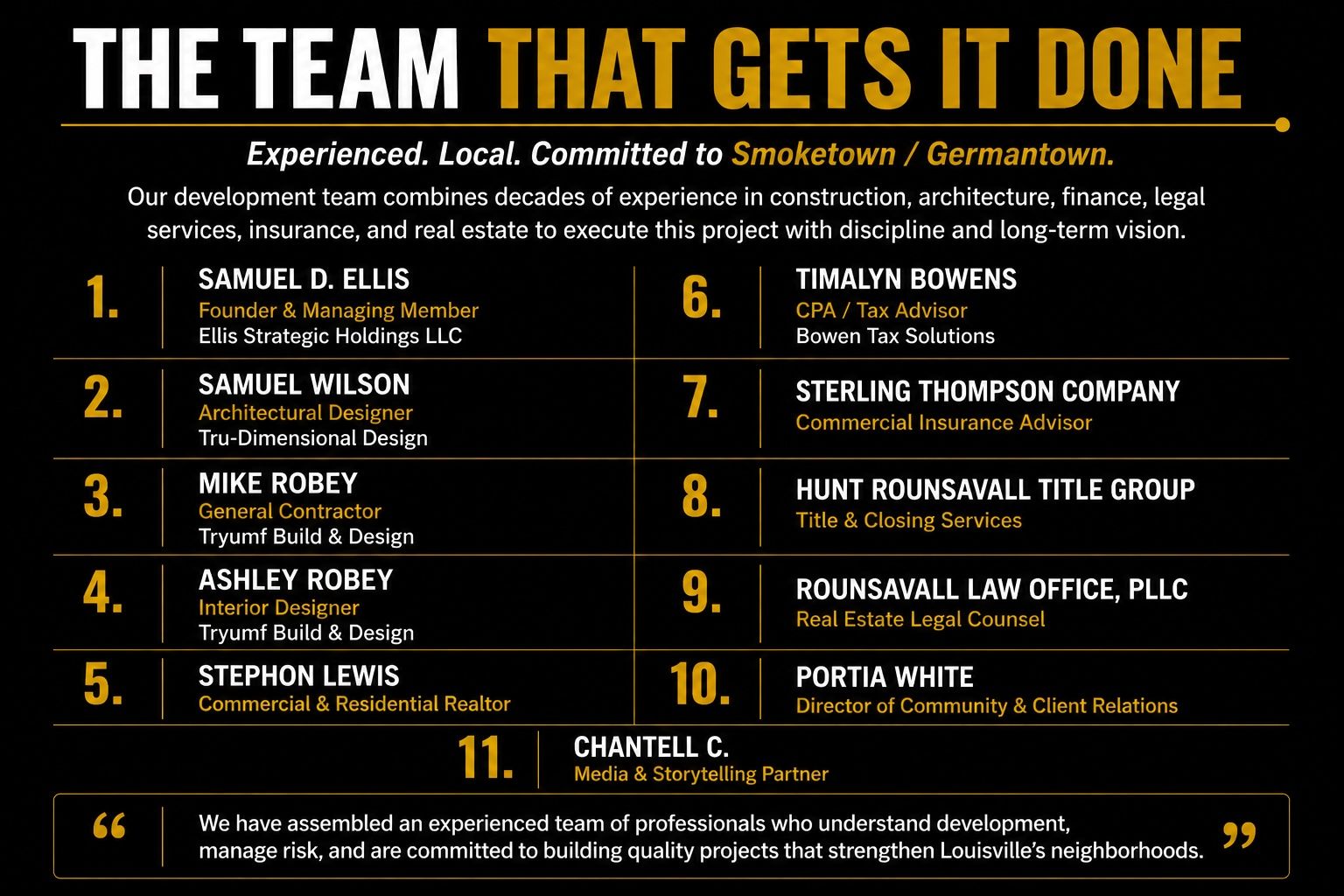

Samuel D. Ellis is the founder of Ellis Strategic Holdings LLC. He brings more than 40 years of construction, property improvement, contractor coordination, and business ownership experience.
Through Ellis Strategic Holdings, Samuel is focused on building a disciplined, long-term real estate development company rooted in practical construction experience, financial responsibility, and neighborhood reinvestment.

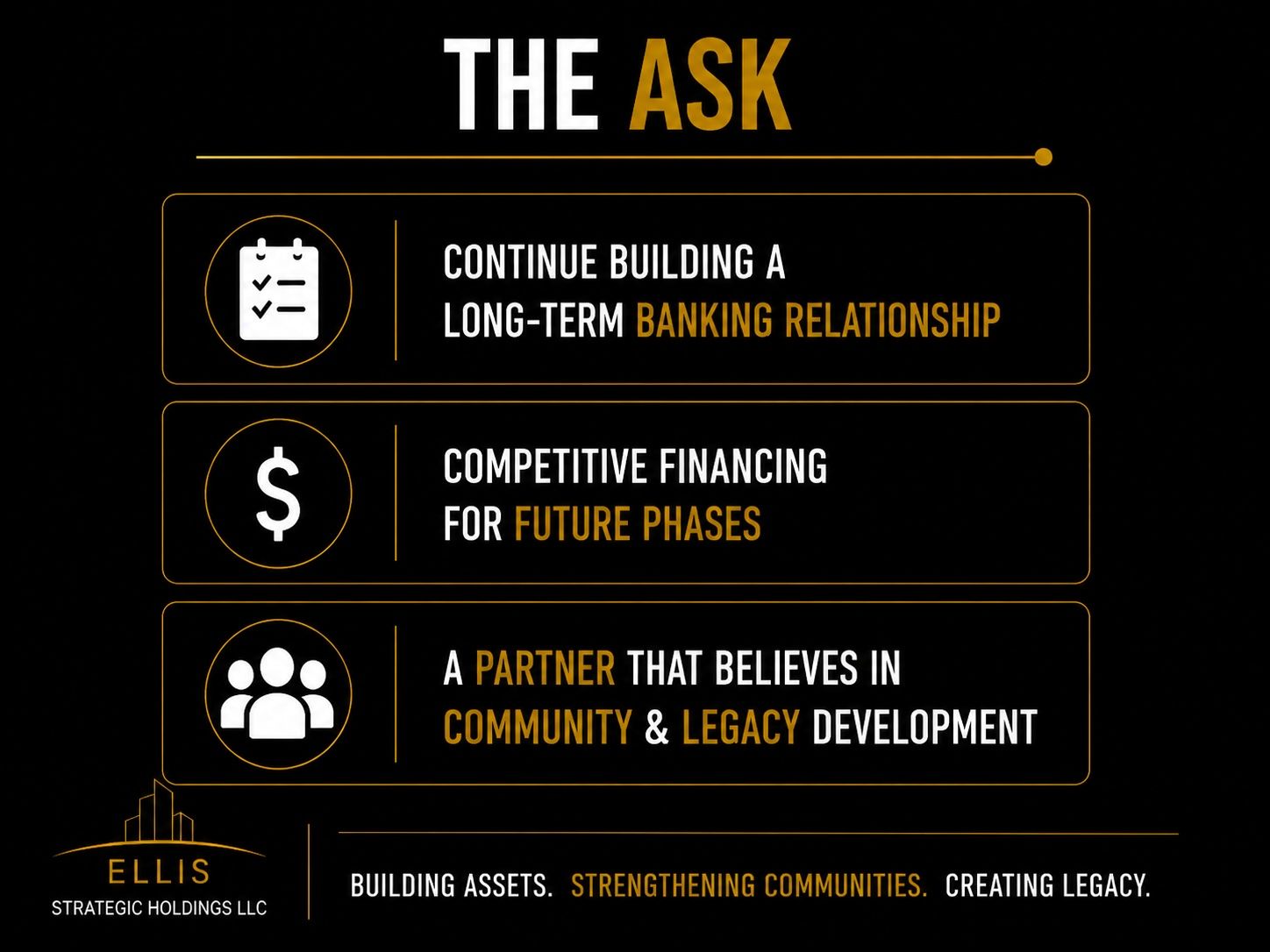

Interested in a Follow-Up Conversation?
I would welcome the opportunity to discuss whether this project fits your lending criteria.
Schedule a Follow-Up Meeting
